Treatment Plant Construction

Memorial Beach Water Treatment Plant

The Town approved the construction of a water filtration plant at the location of the Station #2 well. The treatment plant will remove the iron and manganese from the raw water being pumped from both Station #2 and Station #1. The treatment plant has been on-line and fully functional since January 2020.

December 2019

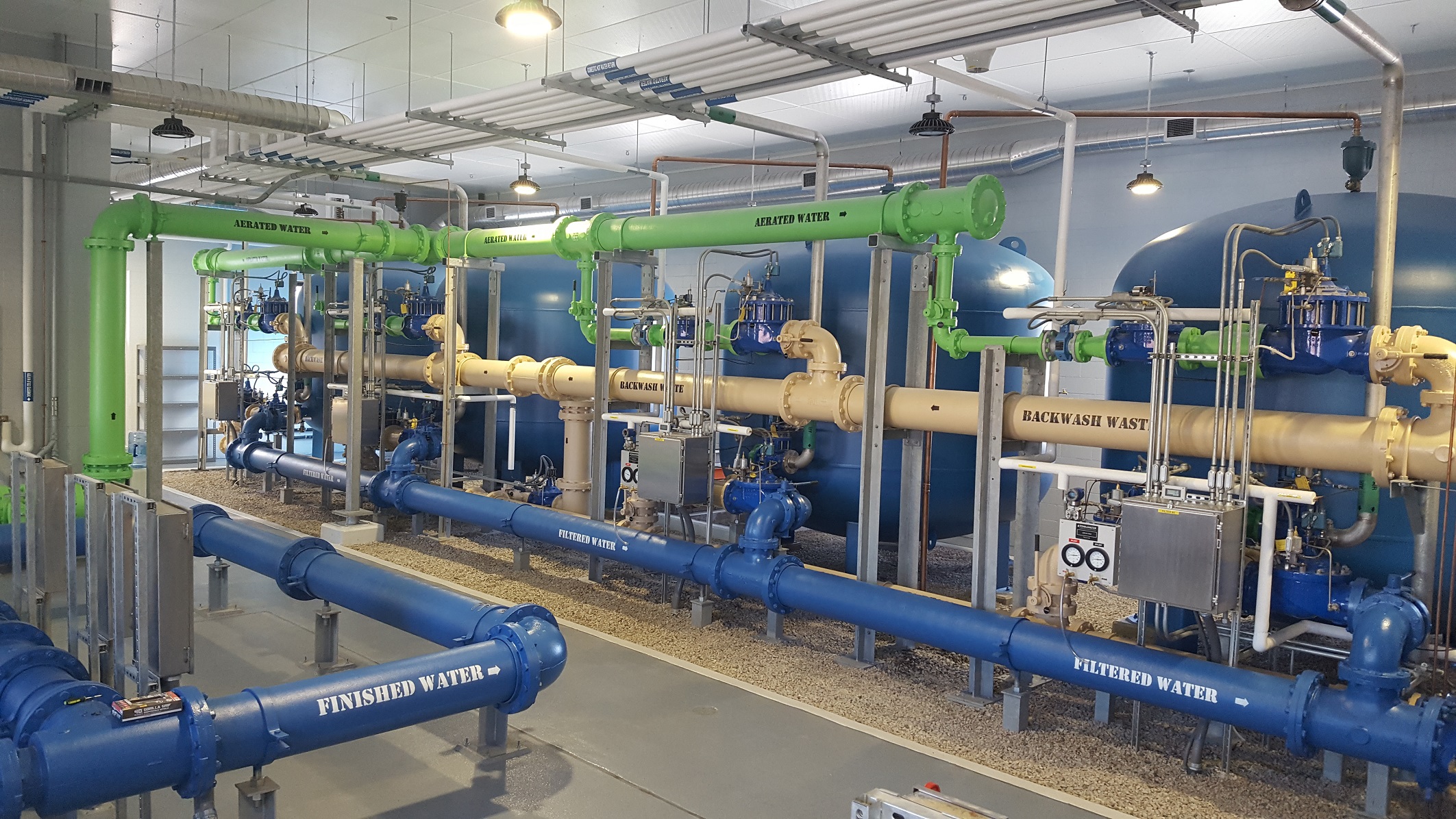

The treatment plant officially started treating water from Station #2 and pumping it into the distribution system on November 25th.  The plant is only running at 650 gallons a minute, or 30% of it's design capacity, from this one well.  Station #1 was taken off-line on December 5th for the renovation of pumps, motors and drives of the five groundwater wells.  The Station #1 wells will be brought on-line in the coming 2-3 weeks and pumped through the treatment plant.  The plant is being operated on a daily basis during business hours during this transitional period because the plant alone cannot meet the needs of the Town.  Station #3 is still supplying a majority of the drinking water to the Town.  As a result to this blending of different water qualities, some residents have experienced a musty taste as the chlorinated water from the treatment plant interacts with the iron and manganese of Station #3. It is anticipated that this issue will continue until the water quality of the distribution system has stabilized.

filter area_small

20191211_113659 small

September 2019

The interior plumbing and mechanical components of the treatment plant have been installed.  The Station #2 well and the three concrete underground storage tanks have been disinfected and are ready for operation.  The last two motor control centers will be shipped in late September and then the plant will begin the "start up" testing procedure for operating with water from Station #2.  Once completed, Station #1 will be taken off-line for its associated upgrades.

20190904_142652_resized_1

April 2019

Tanks and piping AprilThe exterior masonry work has been completed and the interior walls have been painted.  The mechanical pipe work is being assembled between the tanks and pumps. Electrical wiring is being pulled within, and between, the three buildings.

February 2019

tanks rafters small

The roof trusses and sheathing have been installed, as well as the door and window frames. The interior ceiling will be installed once the building is weather tight.  Electrical and fire system conduit is also being installed. Interior piping and pumps have been installed within the aeration building.

January 2019

flying tank

The four 12-foot diameter filter tanks were installed inside the building.  The last sections of concrete slab have been poured and the concrete masonry blocks for the exterior & interior walls are being laid.

November 2018

20181107_145708small

The exterior underground piping along with the interior electrical conduit and drain lines have been installed. The interior of the footings is being backfilled and compacted in preparation for the pouring of the concrete floors. The mason will be on-site this month to begin laying block for the building walls.

September 2018

underground tanks smallThe underground storage tanks have been constructed and tested, and the site is now being back-filled. Foundation footings and yard piping are scheduled to be installed next. Well #2 is also being cleaned in preparation of use.

May 2018

poured slabs 2018small

The pouring of the concrete floors for the clearwell (foreground) and the backwash tank (background).

April 2018

Group 3-1

The groundbreaking ceremony for the new treatment plant was held on April 28th. From left to right: Water Superintendent Greg Woods, former Superintendent Doran Crouse, Tighe & Bond project manager Jeff Faulkner, Selectman Randy Becker, Selectman Andrew Jolda, Senator Ryan Fattman, and Representative Joe McKenna.
